Home Blog Page 4

Data Center Power Flow: Utility to Server Rack Explained

Understanding Data Center Power Flow is critical for engineers, contractors, and facility designers working on mission-critical infrastructure. From the utility grid to the server rack, Data Center Power Flow moves through multiple layers of protection, transformation, conditioning, and distribution to ensure uptime and reliability.

Data centers rely on several interconnected systems.
To understand how these systems work together, see our guide How Data Centers Work.

From the utility grid to the server rack, electrical energy passes through multiple layers of transformation, protection, conditioning, and distribution. Each component exists for one reason: uptime.

This article walks step-by-step through the complete electrical path and explains the purpose of each major system along the way.

1. Utility Power Generation

Every data center begins as a customer of the electrical grid.

Electricity is generated at power plants — natural gas turbines, nuclear facilities, hydroelectric dams, wind farms, or solar arrays. The energy mix varies by region, but regardless of source, power must travel long distances before reaching the data center.

At this stage, the facility has no control. It depends entirely on grid stability.

2. High-Voltage Transmission: Efficiency Over Distance

To move electricity efficiently across long distances, utilities transmit power at very high voltage and low amperage.

Why?

Power loss in transmission lines is proportional to current squared (I²R losses). By increasing voltage, current decreases for the same power level. Lower current reduces line losses and allows smaller conductors relative to delivered capacity.

Transmission voltages may range from 69kV to 500kV depending on region and infrastructure.

Before reaching the facility, power is stepped down at regional substations and delivered to the data center campus at medium voltage.

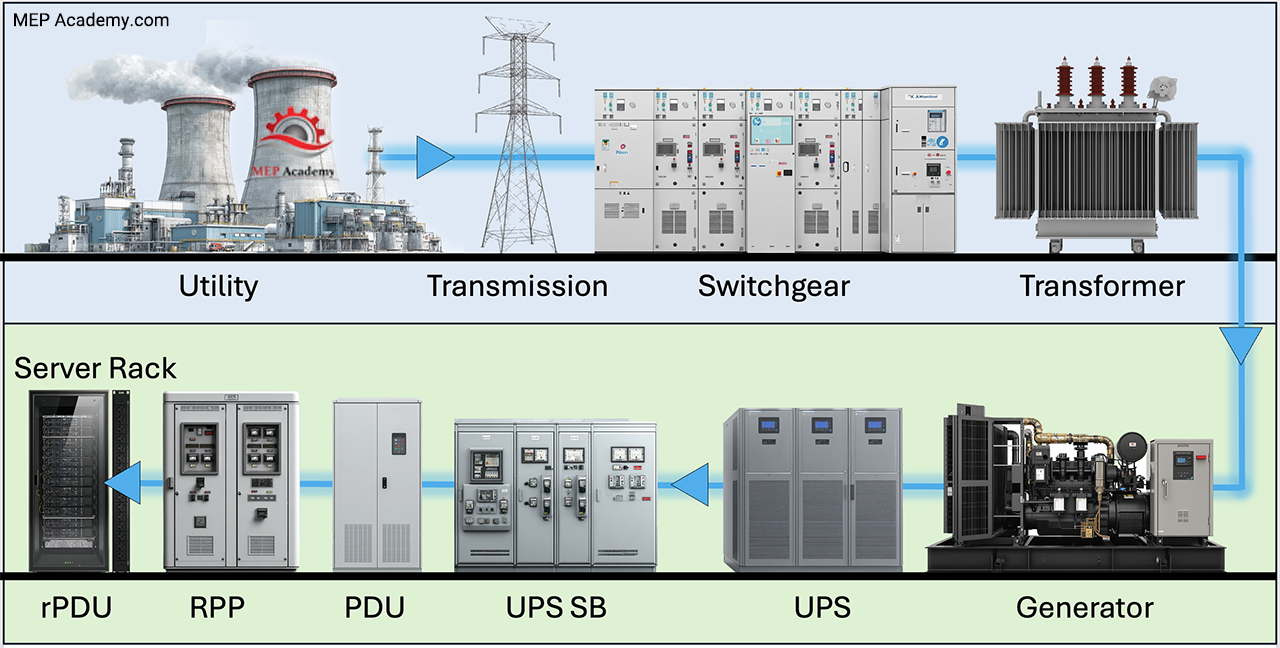

Data Center Electrical Power - From Utility to Server Racks
Data Center Electrical Power – From Utility to Server Racks

3. Service Entrance Switchgear

When power arrives on-site, it enters through service entrance switchgear.

This is the first major piece of electrical infrastructure inside the facility.

Service entrance switchgear:

  • Receives incoming medium-voltage utility power
  • Provides main overcurrent protection
  • Contains protective relays and metering
  • Segments downstream distribution
  • Allows isolation for maintenance

This equipment establishes the facility’s internal electrical control boundary.

From here forward, the data center manages its own reliability.

4. Transformers: Stepping Down Voltage

Utility power typically arrives at medium voltage — often between 12kV and 34.5kV in the United States.

Transformers step this down to low-voltage building distribution levels, commonly 480V.

The transformer performs two critical functions:

  1. Voltage conversion
  2. Electrical isolation

In many facilities, transformers are arranged to support redundancy and load balancing across multiple distribution paths.

5. Generator Paralleling Gear and Automatic Transfer Controls

Utility power is not guaranteed.

If a grid outage occurs, backup generators must take over.

In smaller installations, an Automatic Transfer Switch (ATS) detects utility loss and transfers load to generators.

In larger data centers, transfer logic is integrated into generator paralleling switchgear. This system:

  • Detects voltage abnormalities
  • Starts multiple generators
  • Synchronizes frequency and phase
  • Transfers load safely
  • Manages load sharing between units

This ensures a controlled transition from utility to generator power.

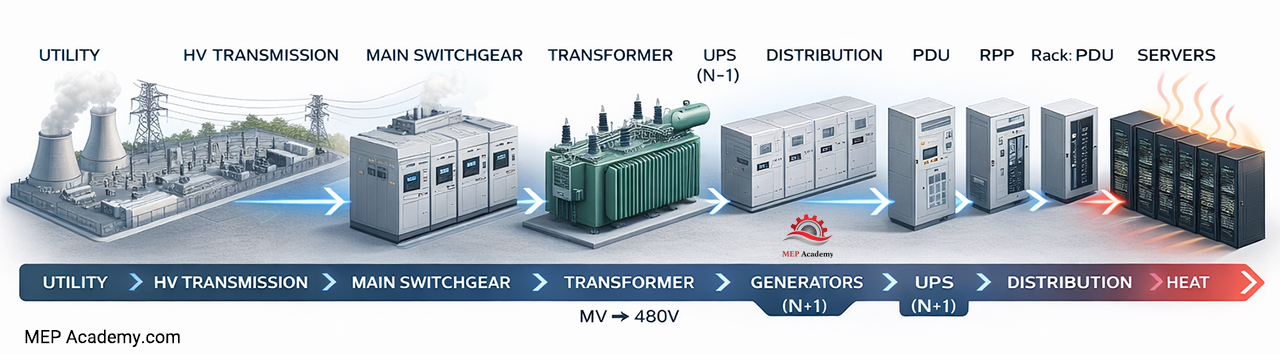

Data Center Electrical Power Diagram
Data Center Electrical Power Diagram

6. Backup Generators and N+1 Redundancy

Backup generators provide full facility power during extended outages.

Most data centers use diesel or natural gas generator systems sized to carry the entire critical load.

Redundancy is key.

In an N+1 configuration, one additional generator is installed beyond what is required to carry the design load. If the facility requires N generators to operate, the +1 unit protects against a single generator failure.

An Uptime Tier II design includes redundant capacity components like extra generators but may not include fully redundant distribution paths.

The objective: no single equipment failure should cause downtime.

7. UPS Systems: Bridging the Gap

Generators take seconds to start and stabilize.

Servers cannot tolerate even milliseconds of interruption.

The Uninterruptible Power Supply (UPS) bridges this gap.

A modern double-conversion UPS:

  • Converts incoming AC to DC
  • Charges batteries
  • Inverts DC back to clean AC output
  • Provides instantaneous ride-through power during transfer events

Historically, UPS systems relied on VRLA (valve-regulated lead-acid) batteries.

Today, high-density facilities increasingly use lithium-ion batteries because they offer:

  • Higher energy density
  • Reduced footprint
  • Longer lifespan
  • Lower maintenance requirements

UPS systems are commonly designed in modular N+1 configurations. If one UPS module fails, the remaining modules continue supporting the load.

Most systems also include static bypass and maintenance bypass capability to allow servicing without shutting down operations.

8. UPS Output Switchboards and Distribution Panels

After conditioning by the UPS, power flows into distribution switchboards.

These panels:

  • Provide breaker protection
  • Segment electrical feeders
  • Support maintenance isolation
  • Feed downstream distribution equipment

At this stage, power is clean, regulated, and protected.

9. Power Distribution Units (PDUs)

Power Distribution Units are typically located near the data hall.

PDUs often:

  • Step voltage from 480V down to 208V or 415V
  • Provide branch circuit protection
  • Monitor electrical loads
  • Distribute power to groups of racks

They serve as the transition between facility-level distribution and rack-level distribution.

10. Remote Power Panels (RPPs)

Remote Power Panels extend branch circuits deeper into the white space.

They provide:

  • Additional breaker capacity
  • Flexible layout configuration
  • Scalability for future expansion

RPPs reduce the need to return to main distribution panels when expanding rack density.

11. Rack Power Distribution Units (rPDUs)

Rack PDUs are mounted directly inside server cabinets.

They distribute electricity to individual servers and network devices.

Modern intelligent rPDUs provide:

  • Per-outlet monitoring
  • Remote switching capability
  • Load balancing data
  • Real-time power consumption metrics

This is the final stage of electrical distribution before energy reaches IT equipment.

12. Servers: Electrical Energy Becomes Heat

When electricity reaches the servers, it is converted into computational work.

Nearly all consumed electrical energy becomes heat.

Every kilowatt delivered must be removed by mechanical systems to maintain safe operating temperatures.

This is the direct relationship between electrical infrastructure and cooling design.

Electrical load equals thermal load.

The Bigger Picture: Power and Uptime

From utility generation to rack-level distribution, the data center electrical system is built in layers:

  • Protection
  • Redundancy
  • Conditioning
  • Segmentation
  • Monitoring

Each layer reduces risk.

Each layer protects uptime.

Understanding this flow is critical for engineers, contractors, and estimators working on mission-critical projects.

In the next phase of the discussion, we follow that same energy — now as heat — into the cooling systems that keep the facility operational.

Data Center Engineering Series

This article is the hub of our Data Center Educational Series, where we break down each major system in detail.

Currently Published

This article is part of our Data Center Engineering Series where we explain how data centers are powered, cooled, and designed.

5 HVAC & Electrical Coordination Mistakes That Cause Change Orders

On many commercial construction projects, HVAC and electrical systems install exactly as shown on the drawings. Equipment is set, Conduit is run. Ductwork and piping is complete. Inspections pass.

Then startup begins — and systems don’t work together.

At that point, the issue usually isn’t installation quality.

It’s coordination.

HVAC electrical coordination problems rarely begin in the field. They start much earlier, during estimating and scope review, when responsibilities between trades are assumed instead of clearly defined.

Below are five of the most common HVAC and electrical coordination mistakes that cause RFIs, change orders, failed inspections, and delayed occupancy.

1. Duct-Mounted Smoke Detector Shutdown Wiring

Duct smoke detectors are physically installed in ductwork, so they are often assumed to belong to the mechanical contractor.

However, these devices:

  • Require electrical power
  • Must interface with the fire alarm system
  • Must shut down air-moving equipment during a smoke event
Duct mounted smoke detector and fire life safety connections
Duct mounted smoke detector and fire life safety connections

Three systems are involved:

  • Mechanical
  • Electrical
  • Fire alarm

Mechanical drawings usually show detector locations.
Electrical drawings may show only general power distribution.
Fire alarm drawings show monitoring points — but not always the shutdown wiring path.

The result?

The detector gets installed — but the shutdown sequence fails during testing.

Building codes typically reference the International Mechanical Code and NFPA 90A for smoke detection in air distribution systems. The coordination issue isn’t the code requirement — it’s making sure power, monitoring, and shutdown wiring responsibilities are clearly assigned before installation.

2. Missing Equipment Disconnect Switches (NEC 430.102(B))

The National Electrical Code requires a disconnecting means within sight of motor-driven equipment.

NEC Article 430.102(B) requires:

A disconnecting means located within sight from the motor and driven machinery location.

This applies to rooftop units, air handlers, exhaust fans, pumps, and similar equipment.

The coordination problem typically occurs because:

NEC 430.102B Requires Disconnect Switches - Coordinate with HVAC and Electrical Contractor
NEC 430.102B Requires Disconnect Switches – Coordinate with HVAC and Electrical Contractor
  • Mechanical drawings show the equipment.
  • Electrical drawings show feeders and panels.
  • Disconnects are not clearly identified.

Mechanical contractors assume the electrical contractor is providing it.

Electrical contractors may exclude it if it is not explicitly shown.

The issue often surfaces only when equipment arrives onsite and no disconnect has been installed — resulting in added cost and schedule impact.

Proper HVAC electrical coordination requires confirming:

  • Disconnect type
  • Amperage rating
  • Mounting location
  • Scope responsibility

Early clarification prevents expensive field corrections.

3. Missing Service Receptacles (NEC 210.63)

Maintenance personnel require power to service equipment safely.

NEC Article 210.63 requires:

A 125-volt, single-phase, 15- or 20-ampere receptacle outlet within 25 feet of HVAC equipment.

Despite this requirement, service receptacles are frequently:

  • Omitted from electrical plans
  • Assumed to be included
  • Not clearly assigned to a trade
NEC Convenience Outlet Requirements NEC 210.63
NEC Convenience Outlet Requirements NEC 210.63

The problem is typically discovered during inspection or turnover.

Late installation may require:

  • Surface conduit
  • Additional roof penetrations
  • Coordination with finished architectural elements

For estimators, this is a critical preconstruction review item.

4. Control Wiring and Building Automation System (BAS) Interfaces

Modern HVAC systems rely heavily on controls and interlocks.

Typical scope boundaries include:

  • Electrical contractor provides power wiring
  • Mechanical contractor provides equipment
  • Controls contractor provides system logic

The gray area often includes:

  • Control transformers
  • Interlock wiring between systems
  • Control conduit installation
  • VFD communication wiring
  • Shutdown signals

Because equipment can power up successfully without these connections fully integrated, coordination issues often appear only during startup or commissioning.

At that point, multiple trades may need to return to complete work that was assumed to be included elsewhere.

Clear scope definition during estimating prevents these late-stage conflicts.

5. Fire Alarm Shutdown Interfaces and System Interlocks

Many HVAC systems are required to stop, start, or change operating mode in response to fire alarm signals.

Mechanical drawings may indicate shutdown intent.
Fire alarm drawings identify monitoring points.
Electrical drawings may not show the interconnecting wiring.

Fire Alarm Shutdown and System Interlocks - HVAC Coordination Issues
Fire Alarm Shutdown and System Interlocks – HVAC Coordination Issues

Common coordination gaps include:

  • Who provides the relay?
  • Who runs wiring to the equipment?
  • Who verifies shutdown sequence during testing?

Each trade may complete its individual scope — yet the system fails functional testing.

This is one of the most expensive coordination failures because it is typically discovered at commissioning.

The Root Cause of HVAC Electrical Coordination Failures

Across all five examples, the underlying issue is the same:

Drawings describe system intent.
Coordination defines execution.

The costliest problems between HVAC and electrical trades are rarely installation errors.

They are scope definition problems that begin during estimating and carry forward into construction.

By the time systems reach startup, the cost of correcting assumptions is significantly higher than identifying them during preconstruction.

How Contractors Prevent These Coordination Problems

Estimators and project managers should:

  • Identify inter-trade coordination items early
  • Qualify proposals clearly
  • Confirm code-required accessories
  • Clarify shutdown and interlock responsibilities
  • Review BAS and fire alarm interface details before bid

Small coordination gaps during estimating become large financial impacts during commissioning.

Final Thoughts

Most HVAC electrical coordination problems don’t begin in the field.

They begin when drawings are interpreted differently, or when responsibilities are assumed instead of clarified.

If you’ve ever had a project where equipment installed perfectly but failed startup due to wiring or shutdown issues, you’ve already experienced this firsthand.

The solution is not more field labor.

The solution is better scope definition.

If you want to strengthen your estimating and preconstruction workflow:

  • Explore our HVAC, Electrical, and Plumbing Estimating Spreadsheets
  • Download our Contractor Construction Forms
  • Check out our Online MEP Training Courses

These tools are designed specifically to help contractors prevent coordination mistakes before they become change orders.

Introduction to AI-Driven Predictive Maintenance

What if you could predict when your HVAC system or mechanical equipment is going to fail — before it happens? Less downtime, lower repair costs, and longer equipment life.

Welcome to the future of maintenance: AI-Driven Predictive Maintenance. In today’s article, we’ll break down what it is, why it matters to HVAC and MEP professionals, and why now is the perfect time to start paying attention.

What is Predictive Maintenance?

Traditionally, maintenance has been either reactive — fix it when it breaks — or preventive — fix it on a schedule whether it needs it or not.

Predictive Maintenance is smarter. It monitors your equipment’s real-time condition and predicts when maintenance is actually needed, based on actual wear and performance — not guesswork.

Where Does AI Come In?

Artificial Intelligence — or AI — takes predictive maintenance to the next level.
“With AI, massive amounts of equipment data — like temperature, vibration, pressure, and energy use — are analyzed in real time.

AI can spot patterns and detect early warning signs of failures that humans might miss.

Why Is This Important for HVAC and MEP Systems?

In HVAC and MEP industries, downtime isn’t just expensive — it can be dangerous, especially in critical facilities like hospitals, data centers, or manufacturing plants.

With predictive maintenance powered by AI, you can:

  • Reduce unexpected downtime
  • Lower maintenance costs
  • Extend equipment life
  • Improve system reliability
  • Enhance safety and compliance

Is AI Just for Big Companies?

Not anymore.
While predictive maintenance started in industries like aerospace and heavy manufacturing, today’s tools — affordable sensors, cloud-based dashboards, even AI-as-a-service platforms — are making it accessible for contractors, engineers, and facilities of all sizes.

Whether you’re managing a few rooftop units or an entire mechanical plant, predictive maintenance can be within reach.

How Do You Get Started?

Getting started with AI-driven predictive maintenance involves three key steps:

  1. Capture the Right Data — from sensors or existing equipment.
  2. Analyze It — using software tools or platforms.
  3. Act on Insights — scheduling maintenance before failures occur.

But implementing a real-world system — choosing the right sensors, setting up dashboards, analyzing trends — takes a bit more know-how.

What’s Next?

If you want to dive deeper — to really understand how AI-driven predictive maintenance works and how you can apply it to HVAC, refrigeration, and MEP systems this is just the beginning. We’ll be covering AI-driven predictive maintenance, smart monitoring, and data-driven decision-making for HVAC and MEP systems in future videos. Subscribe and stay tuned as we continue exploring how AI is changing our industry.

Whether you’re an HVAC technician, engineer, project manager, estimator, or student entering the industry — this course is designed to give you the practical knowledge and skills to stay ahead.

Inside the course, you’ll learn:

  • How to apply these strategies across HVAC, refrigeration, and MEP systems.
  • How to identify the right data points for smarter maintenance.
  • How to set up an AI-powered dashboard — no coding required.
  • How to spot early failure indicators before breakdowns happen.

HVAC VFD Retrofit: Fans, Pumps, Energy Savings, and Retrofit Pitfalls

An HVAC VFD retrofit is one of the most common energy efficiency upgrades applied to existing fans and pumps in commercial buildings. When designed and commissioned correctly, a VFD retrofit can significantly reduce energy consumption at part-load conditions. However, many HVAC VFD retrofit projects underperform due to overlooked mechanical limits, poor controls integration, or incomplete commissioning.

However, in real projects, many VFD retrofits fail to deliver their expected savings—or introduce operational and comfort problems—because the system was never designed for variable-speed operation.

This article walks through the actual retrofit process, the engineering constraints, and the common pitfalls encountered when retrofitting fans, pumps, and motors with VFDs.

1. What a VFD Retrofit Really Is

A VFD retrofit does not simply “add a drive.”
It fundamentally changes how a mechanical system operates.

Before the VFD retrofit:

  • Motor runs at constant speed (typically 60 Hz)
  • Flow or airflow is controlled mechanically (dampers or valves)
  • Energy is wasted during low-demand conditions

After the VFD retrofit:

  • Motor speed varies based on demand
  • Mechanical throttling is reduced or eliminated
  • Energy consumption drops significantly at partial load

The key takeaway:
Energy savings come from reducing speed—not simply installing a drive.

2. When a VFD Retrofit Makes Sense

Not every fan or pump is a good candidate for a VFD retrofit.

Strong VFD candidates include:

  • Systems with variable demand
  • Long annual operating hours
  • Equipment that can tolerate turndown
  • Systems with a measurable control variable

Poor VFD candidates include:

  • Systems with strict minimum airflow requirements
  • Fans operating near surge or stall conditions
  • Equipment with no viable process variable
  • Systems with unresolved comfort or control issues

A VFD does not fix a poorly behaving system—it exposes it.

3. The HVAC Retrofit Process (Step-by-Step)

Step 1: Existing System Evaluation

Before any hardware is specified, the existing system must be understood.

Key questions:

  • What type of fan or pump is installed?
  • Is the motor original or a replacement?
  • Is the system belt-driven or direct-drive?
  • What safeties and interlocks exist today?

Field verification is critical. As-built drawings are often unreliable on older systems.

Here are two possible applications.

Pumps serving Two-way valve system

Remove the existing 3-way control valves and associated bypass piping, and replace them with 2-way modulating valves. This allows chilled water flow to vary with load instead of maintaining constant flow from the supply to the return.

Chilled water constant flow system with 3-way valves before retrofit.
Chilled water constant flow system with 3-way valves before retrofit.

Install a Variable Frequency Drive (VFD) to control the pump motor, first confirming that the motor is rated for VFD duty. If the motor is not VFD-rated, it must be replaced.

Next, install a differential pressure sensor to monitor system pressure as the control valves close. As differential pressure increases, the controller sends a signal to the VFD to reduce pump speed, lowering energy consumption.

Chilled water constant flow system with VFD and 2-way valves after retrofit.
Chilled water constant flow system with VFD and 2-way valves after retrofit.

Finally, verify that the chiller receives the minimum flow required for proper operation. Install a bypass line between the chilled water supply and return near the chiller, sized to maintain minimum evaporator flow when most valves are closed.

Garage Exhaust Systems.

Instead of operating the garage exhaust fan at full speed continuously, install a carbon monoxide (CO) monitoring and control system with multiple CO sensors throughout the garage. These sensors are connected to a Variable Frequency Drive (VFD), which modulates the exhaust fan speed to maintain carbon monoxide concentrations within safe limits.

Garage exhaust system with VFD controlling the fan based on CO levels.
Garage exhaust system with VFD controlling the fan based on CO levels.

When vehicle activity is low and carbon monoxide levels are minimal, the VFD reduces fan speed, significantly lowering energy consumption. As vehicle traffic increases and CO levels rise due to combustion engine operation, the controller automatically increases fan speed to provide the required ventilation and maintain code-compliant indoor air quality.

Step 2: Mechanical Constraints

Mechanical limitations are one of the most overlooked retrofit risks.

Key considerations:

  • Minimum airflow or flow requirements
  • Fan surge and pump cavitation limits
  • Bearing lubrication requirements at low speed
  • Resonance issues on belt-driven equipment

If the equipment cannot operate safely at reduced speeds, energy savings will be limited or nonexistent.

Step 3: Electrical Compatibility

Electrically, a VFD changes how the motor is powered.

Items that must be evaluated:

  • Motor insulation and VFD-duty rating
  • Distance between VFD and motor (reflected wave voltage)
  • Grounding and bonding
  • Harmonics and power quality impacts
  • Existing feeders and disconnect ratings

Many older motors survive VFD retrofits—but not all, and not without risk.

4. Controls: The Most Common Point of Failure

Most underperforming VFD retrofits fail due to controls, not hardware.

A VFD requires a process variable to modulate speed effectively.

Common control strategies:

Frequent control mistakes:

  • Poor sensor placement
  • No minimum speed limits
  • Improper PID tuning
  • Conflicting safeties and overrides
  • No integration with occupancy or schedules

If the control logic is unstable, operators will override it—and energy savings will disappear.

5. Why HVAC VFD retrofit Energy Savings Disappear Over Time

A common retrofit timeline looks like this:

  1. System is commissioned correctly
  2. Occupants experience comfort issues
  3. Operators increase minimum speeds
  4. System slowly returns toward constant speed

Without clear sequences, trending, and operator training, VFDs quietly revert to 60 Hz operation.

Energy retrofits only succeed if the control strategy survives turnover.

6. HVAC VFD retrofit: Estimating and Scope Pitfalls

From an estimating perspective, VFD retrofits often fail because the scope is incomplete.

Frequently missed items:

  • Pressure or flow sensors
  • Control wiring and tubing
  • BAS programming and graphics
  • Commissioning and trend logs
  • Operator training

Most HVAC VFD retrofit change orders originate from controls scope gaps, not mechanical work.

7. Commissioning and Turnover

A successful VFD retrofit includes:

  • Trend data at multiple load conditions
  • Documented sequences of operation
  • Verified minimum and maximum speeds
  • Operator training and setpoint lock-in

Commissioning is not optional—it is where savings are protected.

Final Note

VFD retrofits can deliver substantial energy savings when applied correctly.

They succeed when:

  • The mechanical system can tolerate turndown
  • Electrical limitations are addressed
  • Controls are designed—not improvised
  • Commissioning and training are taken seriously

They fail when VFDs are treated as plug-and-play energy devices.
